Network Diagram Without Lag Consider the below project network diagram. A B Task 2 Task 6 Task 8 Task 9 5 4. F 4 3 E Tas

Business, Finance, Economics, Accounting, Operations Management, Computer Science, Electrical Engineering, Mechanical Engineering, Civil Engineering, Chemical Engineering, Algebra, Precalculus, Statistics and Probabilty, Advanced Math, Physics, Chemistry, Biology, Nursing, Psychology, Certifications, Tests, Prep, and more.
Post Reply
answerhappygod
Site Admin
Posts: 899604
Joined: Mon Aug 02, 2021 8:13 am

Network Diagram Without Lag Consider the below project network diagram. A B Task 2 Task 6 Task 8 Task 9 5 4. F 4 3 E Tas

Post by answerhappygod »

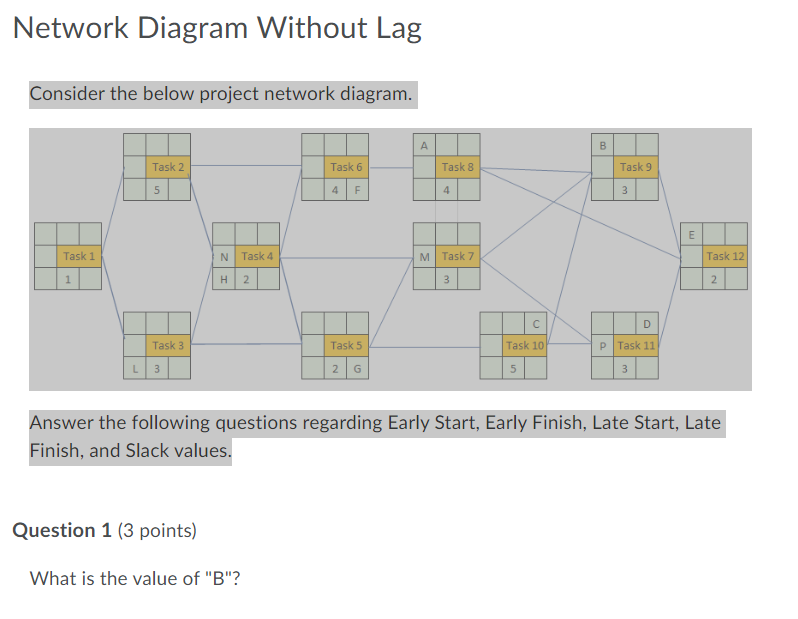

Network Diagram Without Lag Consider The Below Project Network Diagram A B Task 2 Task 6 Task 8 Task 9 5 4 F 4 3 E Tas 1
Network Diagram Without Lag Consider The Below Project Network Diagram A B Task 2 Task 6 Task 8 Task 9 5 4 F 4 3 E Tas 1 (57.28 KiB) Viewed 42 times
Network Diagram Without Lag Consider the below project network diagram. A B Task 2 Task 6 Task 8 Task 9 5 4. F 4 3 E Task 1 N Task 4 MTask 7 Task 12 1 H 2 3 2 С D Task 3 Task 5 Task 10 P Task 11 L 3 2 G 5 3 Answer the following questions regarding Early Start, Early Finish, Late Start, Late Finish, and Slack values. Question 1 (3 points) What is the value of "B"?
What is the value of "B"? 021 017 18 19 O 16
What is the value of "C"? 021 20 15 O 13 O 11
Which of the following tasks are on the critical path. Select as many as needed. Task 11 Task 2 Task 8 Task 12 Task 10 Task 1 Task 6 Task 9 Task 7
What is the value of "A"? 16 10 14 12 13
