1. Create a project schedule for construction of a building project with the following schedule. The start date of proje

Business, Finance, Economics, Accounting, Operations Management, Computer Science, Electrical Engineering, Mechanical Engineering, Civil Engineering, Chemical Engineering, Algebra, Precalculus, Statistics and Probabilty, Advanced Math, Physics, Chemistry, Biology, Nursing, Psychology, Certifications, Tests, Prep, and more.
Post Reply
answerhappygod
Site Admin
Posts: 899604
Joined: Mon Aug 02, 2021 8:13 am

1. Create a project schedule for construction of a building project with the following schedule. The start date of proje

Post by answerhappygod »

1 Create A Project Schedule For Construction Of A Building Project With The Following Schedule The Start Date Of Proje 1
1 Create A Project Schedule For Construction Of A Building Project With The Following Schedule The Start Date Of Proje 1 (170.95 KiB) Viewed 16 times

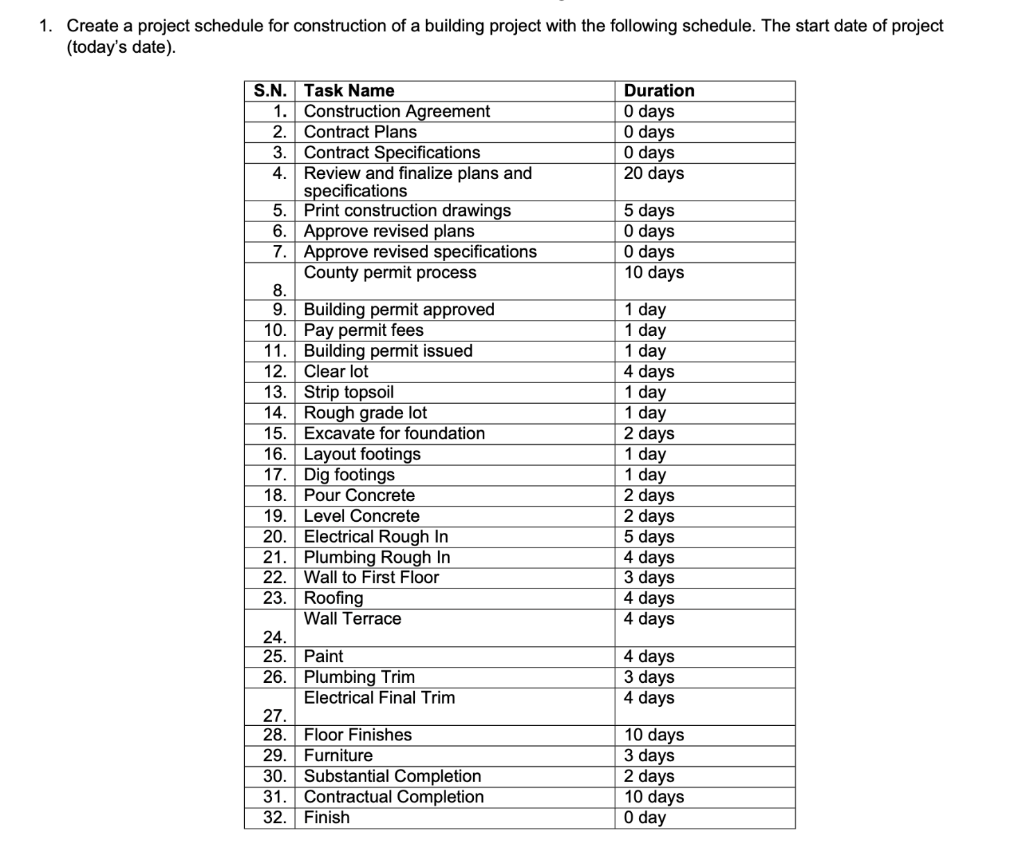

1. Create a project schedule for construction of a building project with the following schedule. The start date of project (today's date). S.N. Task Name Duration 0 days 0 days 1. Construction Agreement 2. Contract Plans 0 days 3. Contract Specifications 20 days 4. Review and finalize plans and specifications 5. Print construction drawings 5 days 0 days 6. Approve revised plans 0 days 7. Approve revised specifications 10 days County permit process 8. 1 day 9. Building permit approved 1 day 10. Pay permit fees 1 day 11. Building permit issued 12. Clear lot 4 days 1 day 13. Strip topsoil 1 day 14. Rough grade lot 2 days 15. Excavate for foundation 1 day 1 day 16. Layout footings 17. Dig footings 18. Pour Concrete 2 days 2 days 19. Level Concrete 5 days 20. Electrical Rough In 4 days 21. Plumbing Rough In 3 days 22. Wall to First Floor 23. Roofing 4 days 4 days Wall Terrace 24. 4 days 25. Paint 3 days 26. Plumbing Trim 4 days 27. 10 days 28. 29. 3 days 2 days 30. 10 days 31. 0 day 32. J. Electrical Final Trim Floor Finishes Furniture Substantial Completion Contractual Completion Finish
2. Write down the start date and end date of the project. The project start and end dates are 16 March 2022 and 5 April 2022 respectively. 3. What are the successor activities of the activity "Roofing?" The name of the successor activities of the activity "Roofing" are Wall terrace Paint 4. What are the IPAS (Immediate Predecessor Activities) of the activity "Floor Finishes?" The IPAs of the activity "Floor Finishes" are Plumbing Trim Electrical final trim 5. If activity "Floor finishes" is delayed by 15 days, will it delay the total duration of the project? If yes, then by how many days and why? Yes. The total duration will be delayed by 15 days, because this activity has only 10days of TF, so the delay will be (15-10) days = 1 day. 6. Write down the names the activities which will not delayed if this project is delayed by 15 days. Write down the reasons why these activities will not be delayed. Building permit issued Clear lot Strip topsoil Rough grade lot Excavate Layout footings Dig footings These activities will not be delayed because they have TF equal to or more than 15days.
7. Write down the names of the activities which will be delayed if the project is delayed by 1 day. Write down the reasons why these activities will be delayed. The following five activities will be delayed if the project is delayed by 1 day, because they are in critical paths and have TF of zero. Pour concrete Level concrete
Electrical rough in Wall to first floor Roofing Wall terrace Paint
