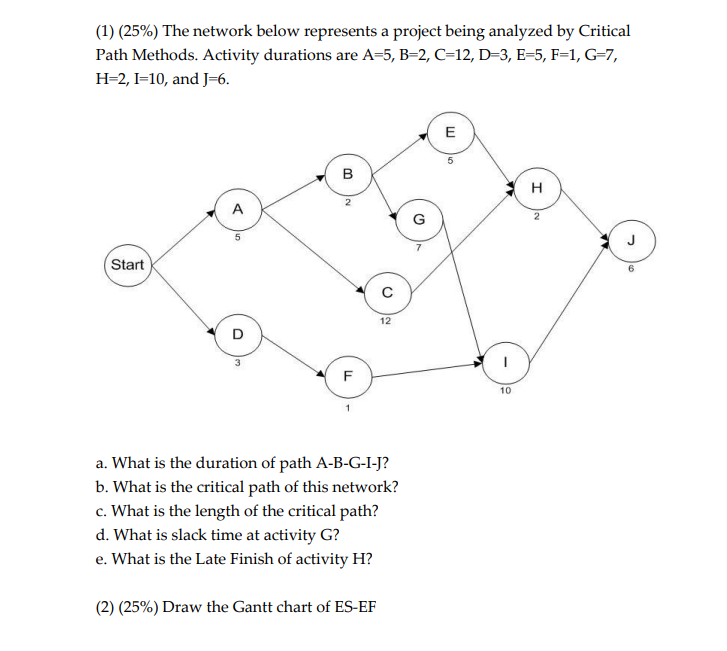

(1) (25%) The network below represents a project being analyzed by Critical Path Methods. Activity durations are A=5, B=
(1) (25%) The network below represents a project being analyzed by Critical Path Methods. Activity durations are A=5, B=2, C=12, D=3, E=5, F=1, G=7, H=2, I=10, and J-6. E 00 B H H A A G Start с 12 D 1 ד 10 1 a. What is the duration of path A-B-G-I-J? b. What is the critical path of this network? c. What is the length of the critical path? d. What is slack time at activity G? e. What is the Late Finish of activity H? (2) (25%) Draw the Gantt chart of ES-EF
